Saturday, November 15, 2008

Watch these 8 videos to start using MS Project 2007

imageA series of 8 video (shot ones) that covers the project management life cycle using MS Project.

it covers the basics of Project Management and will illustrate the Project 2007 interface. It also explain how to start new project, how to define tasks, how to assign resources to tasks, how to estimate the cost and how to report the project progress

here is the link

http://office.microsoft.com/en-us/project/HA102820011033.aspx

Best Regards

Bilal Okour

Sunday, November 2, 2008

25 Microsoft Project Tips and Tricks

tipsA good tips collection from CriticalTools

http://www.criticaltools.com/Tips.htm

Best Regards

Bilal Okour

10 Signs You Don't Really Know Microsoft Project

This is one of the best articles that I ever read, it is highlighting the most BIG MISTAKES that might result in bad outcome of using MS Project

http://www.pmconnection.com/modules.php?name=News&file=article&sid=32

Best Regards

Bilal Okour

Wednesday, October 29, 2008

Microsoft's Theory of I.T.Evolution Event

At IT Evolution 08, get a front row seat as we unveil technologies like Hyper-V, App-V and Virtual Machine Manager that will help you ride the hottest trend in IT today -Virtualization.
Come and attend this big show as per your country schedule below

ms event

Monday, September 1, 2008

Timephased view, It is not there anymore

I have installed the latest infrastructure update for both SharePoint WSS 30.0 and Project Server 2007. I was really impressed with the GREAT enhancement that has been done through.

The most feature I liked was the Timephased view. But I faced one problem where suddenly this view was not showing and i was back to the normal view before applying the infrastructure.

Needless to mention what I did to fix this out but finally I figured it out.  So the reason behind not showing the Timephased view (Calendar view) was because I have modified the My Assignment view and have removed the "Progress [Assignment]" field in the related view.!

This field should be there to get the Timephased view showing correctly, for me I was trying to make this screen simple for my customer and % Work Complete was the main field. That is why I removed the rest.

As a conclusion, don't change the default selected fields for this view in order to get the My Tasks page shows the views as expected.

Best Regards

Bilal Okour

Sunday, August 10, 2008

Articles that I read and would like you to read

A cool article that brings you back to basics, but still it is very important to understand

Subject: Back to Basics: Understanding task dependencies

Best Regards

Bilal Okour

EPM Quick Reference Guide for Project Managers & Team Members

Microsoft published new Quick reference guide for Project Managers and another one for Team members. These are really great where I have been asked by a lot from my customer to provide with such a quick references

Here are the links

For Project Managers: http://office.microsoft.com/en-us/templates/TC102865051033.aspx

For Team Members: http://office.microsoft.com/en-us/templates/TC102880551033.aspx?pid=CT101441451033

now they are free and in Word format

Best Regards

Sunday, August 3, 2008

4 in 1

Did you get the chance to explore the Project server Database, if yes then I am sure that you wonder why there are 4 databases created for each instance of the PWA. I will not answer why but I will till you in brief what is the purpose of each

 arch

  1. The Draft database contains tables for saving unpublished projects from Project Professional and other applications. Project Web Access does not show project data in the Draft database.
  2. The Published database contains all of the published projects as well as enterprise resources, the enterprise global template, and other project templates. Published projects are visible in Project Web Access. The Published database also contains tables that are specific to Project Web Access (timesheets, models, views, and so on), and global data tables (outline codes, security, and metadata).
  3. The Archive database saves backup and older versions of projects and other data.
  4. The Reporting database is the staging area for generating reports and OLAP cubes. Data in the Reporting database is comprehensive and is updated nearly in real time. The Reporting tables are optimized for read-only report generation.

For more details please read this article

http://msdn.microsoft.com/en-us/library/ms513875.aspx

Best Regards

Bilal Okour

Sunday, July 20, 2008

Announcing the Infrastructure Update for Office Servers

Microsoft announced the latest Infra Structure update and it contains a fixes to the claimed bugs.

For more details please visit MSDN Official blog for Project 2007

To download this infrastructure you can follow this link . Install Infrastructure update for Project Professional

Best Regards

Bilal Okour

Sunday, July 13, 2008

Forms Authentication it is amazing but?!!

I have some implementations of the EPM where I used the Forms authentication to authenticate the EPM users. I have wrote my notes and would like to share it with you regarding this

Why to go for Forms Authentication

  1. Some of the EPM users are not part of the organization domain
  2. There is no Active Directory
  3. The user can not access the organization domain

Why NOT to go for that?

Well, do you want me to speak technically or from implementation prospective?

I guess you said both?

  • Technically
    1. leakage of information for MS Sharepoint Forms Authentication as it is not embedded by default
    2. Poor user control functionality.
    3. No out of the box tool for editing users online
  • Implementation
    1. Poor approach to design the security Rules for passwords
    2. Most of the customer forgot their Forms Passwords but they don't do the same with AD passwords
    3. Accordingly getting the users accounts locked, this is not the issue, the issue is the poor approach to get them back.
    4. Integration with Outlook is another bad thing, once you open the outlook and entered your AD password you will get asked to enter your forms credential. Most of my users consider it as a double job that they don't like

Best Regards

Bilal Okour

Tuesday, April 22, 2008

Microsoft Innovation Center (Kuwait) :: Enterprise Project Management Deep Dive Workshop

MIC

Yes, MS EPM is now hitting hard in Kuwait and a lot wanted to start utilizing the power of it. As a series of increasing the awareness and importance of this solution I have conducted a lot of sessions in different large events in Kuwait

The MS EPM flight is landing in MIC (Microsoft Innovation Center, Kuwait) now and the seats are so limited :)

You can download the invitation letter from my blog (please follow this link to download), fill it and email it back to the email address mentioned in the invitation document itself.

The Workshop title will be :: Your Road Map to Project Management using MS EPM Solution and the workshop will cover the following topics (spanned into 5 days, 3 hours a day, 6-9 PM)

Day 1

Getting Started with Office Project Server 2007

Initiating Projects

Planning Projects—Context and Framework

Day 2

Planning Projects—Scope and Schedule Management

Planning Projects—Staffing Management Plan

Planning Projects—Resource Assignments

Day 3

Planning Projects—Cost, Risk and Other Management Plans

Executing Projects—Processes, Resources, and Deliverables

Executing Projects—Manage Timesheets and Personal Settings

Day 4

Monitoring and Controlling Projects—Context and Framework

Monitoring and Controlling Projects—Tracking Task and Project Progress

Day 5

Monitoring and Controlling Projects—Measuring Performance and Reporting Progress

Closing Projects

Complete Life Cycle case

For more information you can

Call me at +965 7205246

Email me: bilal@arabilla.net

Or post a comment here

Best Regards

Bilal Okour

Sunday, April 20, 2008

MS Project Server 2007 Best Practice :: Forms vs Windows Authentication

I guess so many people are happy with the windows authentication features that comes with MS Project Server and found it very easy to setup and to use. But did they know that there is another way of authenticating users, i am sure that they knew but they never think when and how to use it

Authentication

First let me focus on facts about each and when each one is recommended to be used?

Windows Authentication

  • It is authenticate users against the AD that the Project Server is joint to. So, it can use only one AD. So if all of your users are belongs to one domain then this will be your right choice.
  • Roles and groups (or any AD classification) are not used in EPM, remember that the title is all about Authentication, not authorization. Authorization is run through the security model embedded with the Project server itself.
  • Project Server users list and the AD users list is not an linked. You need to schedule synch job from within Project Server itself from time to time, this means if user has became inactive then this will not be reflected into the Project Server. (needless to say that if the user became inactive or blocked in AD then he/she will not get authenticated to AD but he can be still used as a resource in Project Server)

Forms Authentication

  • Conceptually, it is very similar to the AD authentication, except that Membership Provider will be used instead of AD
  • More flexible to contain users regardless of the AD they belongs and even if they don't belong to any AD
  • Difficult (or not straight forward to setup) to setup and maintain the users credentials.
  • No synch tool is available out of the box except for the "PjFormsAuthUpgrade" tool that comes with Project server

I will be posting more articles about Forms authentication, be tuned

Best Regards

Bilal Okour

Sunday, April 6, 2008

MS Project Server 2007 Best Practice :: submit, approve, apply and publish

The confusion of how to use the EPM in the right way is common everywhere. The main two player in this environment (Project Managers & Team Members) find sometimes difficult to understand why the EPM is not reflecting the progress information for any published project. To understand this you can take it simply like this

  1. PM :: Publish the project to PWA (Using Project Pro)
  2. Team Resource :: Submit the progress update to his PM (using PWA)
  3. PM :: Approve the updates received by his resources (using Project Pro)
  4. PM :: Apply the approved updates to be reflected into the plan  (Using Project Pro)
  5. PM :: Adjust (if required) and then Publish the project plan again to PWA (using Project Pro)

The picture below can tell this in a better way

Best Practice

Best Regards

Bilal Okour

Tuesday, April 1, 2008

Microsoft Technology Day, Don't miss it next year

  Yes, I mean it, 45 sessions that touched the latest related to Microsoft were shown at the biggest event in  Kuwait. I hope you did attend your favorites topics and get the maximum benefits.

Now back to my sessions, the two rooms allocated for my sessions were full. I was expecting that due to the extensive registrations on my sessions during the registration time. At a moment I said, thanks God, I did good preparation for such an audience. It would have been a big loss if I did not do so.

pic1-88x60 pic19-600x399
pic6-600x400 DSC03564
DSC03574 pic24-600x400

The first session were about administrative part of EPM, the 2nd and 3rd were about the best practice  for Project Managers and the other main players in EPM environment.

Last one, it was supposed to be about Monitoring and Controlling, but I was able to cover part of it only, the rest inshalla will be conducted in the future in a separate session

I have announced www.pmroad.com as the first community for Project Managers in Kuwait. also I announced the start publishing of a series about the best practice in EPM on my blog

So, my recommendation for you "From now and over, don's miss any event related to the main communities in kuwait (dotNetboom, ProRangers and msexperts) and expect it to be always BIG by default"

Best Regards

Bilal Okour

Tuesday, March 4, 2008

I am leaving the building

Only today I have took the sharp decision to move to new company, big, challenged and in a role of MIS Manager.

ed&f   In my new position I will be responsible for designing and implementing Management Information systems based on Microsoft Technologies. I am still new to the new company so I can not till more about it except that I am very optimistic for this movement I made.

For my x-company, I had to admit that I got impressed of the company style and reputation. I met hundreds of professional people there and made good connections. So I would like to say that I feel proud that I worked in Agility.

Note: Needless to mention that the photo in this post is NEITHER my new office NOR my old one, it is just a one I took from the web. enjoy !

Best Regards

Bilal Okour, Kuwait, 4th March 2008

Sunday, March 2, 2008

MS Project 2007 ::What are the available reports

Task Usage category

Name

Type

Description

Cash Flow Report

Excel

Use this report to view a bar graph with cost and cumulative cost amounts illustrated over time.

Earned Value Over Time Report

Excel

Use this report to view a chart that plots AC (actual cost of work performed), planned value (budgeted cost of work scheduled), and earned value (budgeted cost of work performed) over time.

Resource Usage category

Name

Type

Description

Cash Flow Report

Visio

Use this report to view a diagram that shows planned and actual costs for your project over time. Costs are broken down by resource type (work, material, and cost). An indicator shows if planned costs exceed baseline costs.

Resource Availability Report

Visio

Use this report to view a diagram that shows the work and remaining availability for your project's resources, broken down by resource type (work, material, and cost). A red flag is displayed next to each resource that is over allocated.

Resource Cost Summary Report

Excel

Use this report to view a pie chart that illustrates the division of resource cost between the three resource types: cost, material, and work.

Resource Work Availability Report

Excel

Use this report to view a bar graph with total capacity, work, and remaining availability for work resources illustrated over time.

Resource Work Summary Report

Excel

Use this report to view a bar graph with total resource capacity, work, remaining availability, and actual work illustrated in work units.

Assignment Usage category

Name

Type

Description

Baseline Cost Report

Excel

Use this report to view a bar graph with baseline cost, planned cost, and actual cost for your project illustrated across tasks.

Baseline Report

Visio

Use this report to view a diagram of your project broken down by quarter, then by task. This report compares planned work and cost to baseline work and cost. Indicators are used to show when planned work exceeds baseline work, and when planned cost exceeds baseline cost.

Baseline Work Report

Excel

Use this report to view a bar graph with baseline work, planned work, and actual work for your project illustrated across tasks.

Budget Cost Report

Excel

Use this report to view a bar graph with budget cost, baseline cost, planned cost, and actual cost illustrated over time.

Budget Work Report

Excel

Use this report to view a bar graph with budget work, baseline work, planned work, and actual work illustrated over time.

Task, Resource, and Assignment Summary categories

Category

Name

Type

Description

Task Summary

Critical Tasks Status Report

Visio

Use this report to view a diagram showing the work and remaining work for both critical and non-critical tasks. The data bar indicates the percent of work complete.

Task Summary

Task Status Report

Visio

Use this report to view a diagram of the work and percent of work complete for tasks in your project, with symbols indicating when baseline work exceeds work, when baseline work equals work, and when work exceeds baseline work. The data bar indicates the percent of work complete.

Resource Summary

Resource Remaining Work Report

Excel

Use this report to view a bar graph with remaining work and actual work for each work resource, illustrated in work units.

Assignment Summary

Resource Status Report

Visio

Use this report to view a diagram of the work and cost values for each of your project's resources. The percent of work complete is indicated by the shading in each of the boxes on the diagram. The shading gets darker as the resource nears completion of the assigned work.

Saturday, March 1, 2008

MS Project 2007 :: Timesheet status

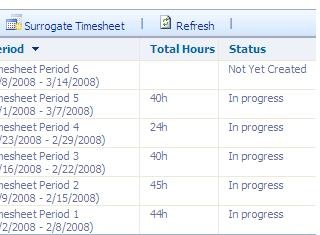

The following Status Definitions are available:TS

  • In Progress. The Timesheet is built by the team member. Data may be saved. Nothing is submitted.

  • Rejected. The Timesheet is rejected by a Timesheet Manager.

  • Submitted. The Timesheet is sent to the first-level Timesheet Manager for review.

  • Acceptable. The Timesheet is accepted by a Timesheet Manager and is sent to the next approver.

  • Approved. The Timesheet is approved by a Timesheet Manager at any level.

  • Error. An error occurred when the Timesheet was processed.

Best Regards

Bilal Okour

Thursday, February 21, 2008

MS Project 2007 :: installing SP1 result in Stopping Microsoft Office Project Server Events Service

sw_testingYes, this true because it happened with me, after installing WSS 3.0 SP1 I started installing Ms Project Server 2007 SP1, exactly in step 5 it stop and throw an exception tilling that the Microsoft Office Project Server Events Service was not able to get started !!??

After searching completely the "Whole Internet" I found one post talking about this issue

and what I came to know that this service trying to access the Internet address

http://crl.microsoft.com/pki/crl/products/CodeSignPCA.crl

but the network setup did not allow this (this is true and expected for the ideal and secure network). I was sure that this is my issue that stopped me from completing my work in the last 2 days.

So, the only solution suggested by my colleagues in Networks and Systems department is to allow Internet Access in complete during the installation of SP1 then remove it

It work, yes, but for me I consider this a stupid bug regardless of the person who wrote the code unless it is a policy to catch the people who are using the unlicensed copies

Best Regards

Bilal Okour

MS Project Server 2007 :: How to install it in a single mode

Hi folks

I found this article good for the people who are going to deploy Project Server 2007 in a stand alone computer

http://technet2.microsoft.com/Office/en-us/library/c9531164-2705-4233-84d1-78bd728dd7611033.mspx

Best Regards

Bilal Okour

Tuesday, February 19, 2008

MS Project 2007 :: Corrupted Tasks

How do you know if your Project has a corrupted tasks, simply the following indicators will till you if so

  1. One ore more of your resource report that his "My Taks" is showing sharepoint error message

    my tasks error
  2. If you know how to query your database (Published DB of your server) and get unfortunately one row at lease

    SELECT MSP_PROJECTS.PROJ_NAME, MSP_ASSIGNMENTS_SAVED.TASK_NAME,
    MSP_RESOURCES.RES_NAME, MSP_ASSIGNMENTS_SAVED.ASSN_UID,
    MSP_ASSIGNMENTS_SAVED.PROJ_UID,
    MSP_ASSIGNMENTS_SAVED.TASK_UID, MSP_ASSIGNMENTS_SAVED.RES_UID
    FROM MSP_ASSIGNMENTS_SAVED INNER JOIN
    MSP_PROJECTS ON MSP_ASSIGNMENTS_SAVED.PROJ_UID =
    MSP_PROJECTS.PROJ_UID INNER JOIN
    MSP_RESOURCES ON MSP_ASSIGNMENTS_SAVED.RES_UID =
    MSP_RESOURCES.RES_UID
    WHERE (NOT EXISTS
    (SELECT TASK_UID
    FROM MSP_TASKS_SAVED
    WHERE (TASK_UID =
    MSP_ASSIGNMENTS_SAVED.TASK_UID)))

    Then to resolve this issue do the following

  • Open Gantt View, Insert "Publish" column, and select No for the task that you got from the above query
  • Publish your project
  • Again Gantt View, For the  "Publish" column, and select "Yes" for the task that you got from the above query
  • Publish you project

Best Regards

Bilal Okour

MS Project :: You need to know these terms

Here are some useful interpretation

Duration = Actual Duration + Remaining Duration
Percent (%) Complete = Actual Duration / Duration
Work = Actual Work + Remaining Work
Percent (%) of Work Complete = Actual Work / Work

Start: At the beginning it is the baselined start, later one it will be replaced by the actual start
Finish: At the beginning it is the baselined finish, later one it will be replaced by the actual finish

Note: Remember to baseline your plan to save the original values

Best Regards

Bilal Okour

Friday, February 15, 2008

MS Project :: You need to know these terms

Here are some useful interpretation

Duration = Actual Duration + Remaining Duration
Percent (%) Complete = Actual Duration / Duration
Work = Actual Work + Remaining Work
Percent (%) of Work Complete = Actual Work / Work

Best Regards

Bilal Okour

Saturday, February 2, 2008

I will be speaking in 2 big events in Kuwait

Dear All,

for all who are interesting in understanding Microsoft EPM solution then they can attend my sessions at the following two major events

  1. Community Open Day, executed by DotNetBoom and ProRangers communities and sponsored by Microsoft. Here I will conduct 2 sessions which will cover how Microsoft EPM can be best implemented to Manage the IT projects during all phases in the IT Development Life Cycle.
  2. MVPs Open Day, the first event in Kuwait where different MVPs from Middle East, Africa and Europe will be gathering together to unleash the latest technology experience they have. I am sure that you will never feel that you lost one minute of your time. Waiting to see you there

More details will come soon and I will make sure to keep you updated

Best Regards

Bilal Okour

Friday, February 1, 2008

MS Project 2007: Examples about Tasks Types

A lot of project mangers using EPM solution are keeping asking me about giving examples to illustrate the different types of MS Project 2007 Tasks Types

Here I am trying to give some examples

Fixed Duration

  • The football match will take 90 minutes to finish
  • Flying from Kuwait to Amman will take 1:30 hour to complete regardless of the number of the passengers inside and regardless of the number of aircrafts flying at the same time
  • The woman will take 9 months to deliver, you cannot divide this work for two resources (she and her girl friend)

Fixed Work

  • You are required to enter 2000 records into an application, each record will take 5 minutes and you will pay (or get paid) per record.
  • You are required to floor 100 square meters of one building, each square meter will take 30 minutes.
  • You want to install Windows XP on 100 boxes, each box will take 1 hour and you need to pay (or get paid) per each installation.

Fixed Unit

  • You want 1 developer to work 8 hours (100% or full day only) to develop a program
  • You need 5 developers and each to work 20% of their capacities to complete the program
  • You need 5 developers to work 8 hours a day (100% each) to complete the program
  • You need 1 developer to work 4 hours a day (50% or half timer) to complete the program

Best Regards

Bilal Okour

A MS Project 2007 Crazy Error: My Tasks is now not working???

I have completed one installation and implementation for PS2k7 at one organization, it worked fine for around 2 months, suddenly the My task did not work for some users but it is working for the others

I knew that there is a corrupted assignment and the only solution for me was to roll out the project from the last copy just before the issue starts

I found this post in the Internet that approach this issue in a very logical way, the suggested solution can figure out the corrupted task and gives a walk around solution for this,  and it was posted by: Rod Gill, Microsoft MVP for Project

for more details about Rod please check the button of this post

Now I will let you with the  post

"

if you add a new resource that already has % complete>0 then
there is still a bug (after SP1) that causes a corrupt assignment. The
symptoms are that the resource cannot access My Tasks.
The following SQL will highlight which assignment is corrupted:

SELECT MSP_PROJECTS.PROJ_NAME, MSP_ASSIGNMENTS_SAVED.TASK_NAME,
MSP_RESOURCES.RES_NAME, MSP_ASSIGNMENTS_SAVED.ASSN_UID,
MSP_ASSIGNMENTS_SAVED.PROJ_UID,
MSP_ASSIGNMENTS_SAVED.TASK_UID, MSP_ASSIGNMENTS_SAVED.RES_UID
FROM MSP_ASSIGNMENTS_SAVED INNER JOIN
MSP_PROJECTS ON MSP_ASSIGNMENTS_SAVED.PROJ_UID =
MSP_PROJECTS.PROJ_UID INNER JOIN
MSP_RESOURCES ON MSP_ASSIGNMENTS_SAVED.RES_UID =
MSP_RESOURCES.RES_UID
WHERE (NOT EXISTS
(SELECT TASK_UID
FROM MSP_TASKS_SAVED
WHERE (TASK_UID =
MSP_ASSIGNMENTS_SAVED.TASK_UID)))
--Run against Published Database
As far as I'm aware the only work around is not to add a new assignment to a
partially completed task. Instead create a copy of the task and assign the
new resource to it. A pain I know!

Rod Gill,

Microsoft MVP for Project

Author of the only book on Microsoft Project VBA. For details visit:
http://www.projectvbabook.com

"

Best Regards

Bilal Okour

Thursday, January 31, 2008

Using Project Server 2007’s Reporting Database and SQL Server Reporting Services 2005

Hi folks

I really love gong back to programming if I could manage to get the chance to do so

Today I was completely impressed by this article I read from Project Programmability blog

if you have time you can read it

http://blogs.msdn.com/project_programmability/archive/2008/01/03/implementing-my-tasks-read-only-custom-fields.aspx

Best Regards

Bilal Okour

Wednesday, January 30, 2008

MS Project 2007: Why and How to split a Task

let me answer the first question: why to split a Task, the answer for this is

  • Either you want to interrupt some work with an other (By You)
  • Or by leveling the resource to maintain the work balance (By the system)

For the second question How??

To split a Task do the following

  1. Open the project using Project Professional 2007 (you need to give the user the following permission "Log on to Project Server from Project Professional" from the Global Permission )
  2. Open Gantt view, click on Split Task
  3. On the bar, click on the place where you want the split to be applied
  4. Drag and drop the second portion of the bar to the new location in the chart (new date)

Best Regards

Bilal Okour

Wednesday, January 23, 2008

MS Project 2007 :: The first 4 Steps to start using Cubes

In this post I will explain the steps required to make your Database Server (I am talking about SQL 2000) ready for MS Project 2007 Cube Building

1) Verifying and Installing Analysis Services SP4

  • From Control Panel ==> Add Remove Programs ==> Microsoft Sql 2000 Analysis Services ==> Click here for support information, make sure that the SP version is 8.00.2039
  • If the SP4 is not installed proceed with next step, otherwise you can leave now :)
  • Go to the Microsoft (http://go.microsoft.com/fwlink/?LinkId=86989).
  • Download the Analysis Services Components (download file: SQL2000.AS-KB884525-SP4-x86.EXE).
  • When you run the download, you are prompted to select a location for saving the file. After specifying the location, click Next. The files will be extracted to this location.
  • Click Finished.
  • Browse to the location you specified on the server and run \msolap\install\Setup.exe.
  • Follow the directions that appear to complete the installation of the service pack.

2) Adding the Queue service account to the OLAP Administrators group

  • From the Start menu, click Programs, click Administrative Tools, and then click Computer Management.
  • In Computer Management, expand Local Users and Groups and then click the Groups folder.
  • Double-click the OLAP Administrators group to open the properties page.
  • In the properties page, click Add.
  • On the Select Users, Computers, or Groups page, in the Enter Object Names to select box, enter the Windows user account under which the Queue Service is running. Click OK.
  • In the OLAP Administrators property page, click OK

3) Granting the OLAP Administrators group permissions to the SQL Server 2000 Analysis Services components

  • Using windows Explorer, browse to "C:\Program Files\Microsoft Analysis Services\Bin" or what is ever you installation folder for Microsoft Analysis Services
  • Right click on bin folder
  • Select "Properties"
  • Select Security tap
  • Click on Add to add the OLAP Administrators and give this group a Full Control permissions
  • Click on Apply, then Ok

4) Grant permissions to the SQL Server Analysis Services service account to access the Project Server Reporting database

  • From the Start menu, select Programs, select Microsoft SQL Server, and then click Enterprise Manager.
  • In Enterprise Manager, expand Microsoft SQL Servers, SQL Server group, and the server.
  • Expand the Security folder, right-click Logins, and then click New Login.
  • On the properties page, in the General tab, enter the Windows Authenticated account for the user running the SQL Server Analysis Services service.
  • Click the Database Access tab.
  • Enable Permit for the Project Server Reporting database(s).
  • In the Permit in Database Role section, enable db_datareader permissions for the Project Server Reporting database(s).
  • Click OK

Best Regards

Bilal Okour
